Construction & Electrical Update from EG CELESTE E INIZIO
- Nova Rise Group

- 1 day ago
- 2 min read
An incredible amount of work goes into a utility-scale solar project before the first clean electron hits the grid. Right now, the focus at EG CELESTE E INIZIO is heavily subterranean. From laying structural foundations to digging out critical power pathways, our teams are working side-by-side to conquer some of the toughest terrain challenges yet.
Building a clean energy future isn't always smooth sailing—sometimes, it’s downright rocky. Here is a comprehensive look at our utility-scale solar progress across both the civil and electrical phases of construction.
1. Civil & Structural Update: The Piling Phase Begins
The team has officially kicked off the piling phase, marking a massive step forward in establishing the structural foundation for the entire project.

Facing the Terrain Head-On
Every great project presents its own unique set of geological puzzles. At EG CELESTE E INIZIO, the underground terrain has proven to be incredibly rocky, paired with serious denivelation (elevation changes) across the site.
These underground conditions mean that standard ramming alone is difficult. To ensure the absolute stability of our axial structure, our engineering and construction teams are adapting swiftly:
Pre-drilling Preparation: We are currently setting up specialized pre-drilling equipment to penetrate the dense rock layer before the piles are driven.
Precision Engineering: With a total of 8,200 piles required for the project, precision is non-negotiable.
Behind the Scenes
While the heavy machinery works the field, the logistics team is preparing materials. Piles are currently being sanded and meticulously prepared for hot-dip galvanization. This crucial step ensures that the foundation of our axial structures will withstand the elements and resist corrosion for decades to come.
What’s Next? With the pre-drilling setup wrapping up, we are on track to begin structure assembly next week.
2. Electrical Infrastructure: Navigating Subterranean Obstacles

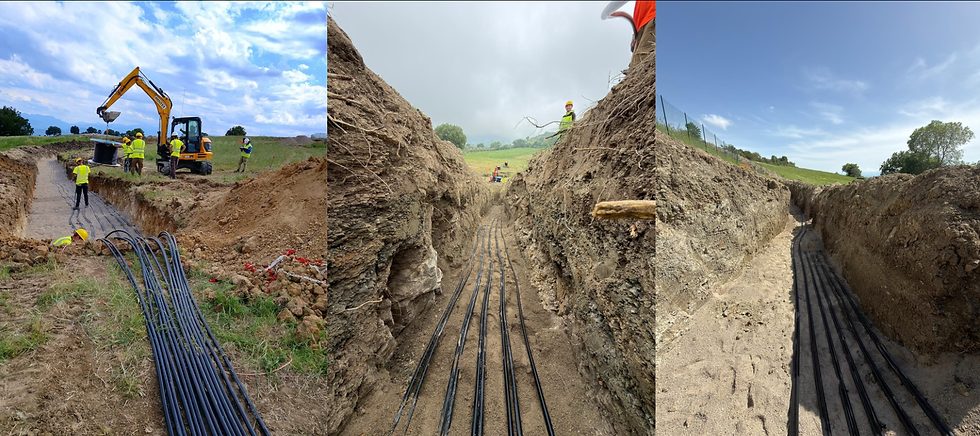

While the civil teams prepare the ground upward, our electrical crews are focused downward. We are making steady headway on the critical solar electrical trenching that will serve as the project's central nervous system.
Adapting to the Landscape: Deep & Wide Utility-scale solar progress
Because of the significant denivelation across our project site, standard trench depths simply won't cut it. To maintain safety and regulatory compliance, our team is digging trenches up to 2 meters deep and 1.5 meters wide.
Executing this scale of excavation on a rocky, difficult terrain requires heavy-duty machinery. To cut through the stubborn, large rock formations, we have deployed excavators equipped with hydraulic hammer attachments to break the stone down piece by piece.

By The Numbers: Trenching Progress
Despite the tough geology, our crews are maintaining an impressive pace. Out of the 6,000 meters of total trenching required for the project, here is where we stand today:
Infrastructure Component | Progress Percentage | Status |
Total Linear Trenching | ~28% Complete | 1,700m excavated out of 6,000m |
Medium Voltage (MV) Trenching | 50% Complete | Halfway milestone reached |
Low Voltage (LV) Trenching | 40% Complete | Steadily advancing |
Moving Forward Together

By investing the time and machinery into breaking rock, pre-drilling, and digging deep today, we are ensuring that EG CELESTE E INIZIO is built to last for the long haul. Step by step, the skeleton and internal grid of this flagship project are taking shape.
Stay tuned for our next site update as we clear these rocky hurdles and keep the momentum going!
